Metro Approval Sets Stage for Construction of NoHo-Pasadena Bus Rapid Transit Line

$135M approved today will take the NoHo-Pasadena BRT project through the next two years. If this preconstruction phase goes as planned, the project will ramp up to full construction by 2027.
4:18 PM PST on December 5, 2024
Metro Approval Sets Stage for Construction of NoHo-Pasadena Bus Rapid Transit Line
Rendering of NoHo-Pasadena center-running bus lanes design for Colorado Boulevard at Eagle Rock Blvd
LongBeachize_Ad_Concepts
This article supported by Los Angeles Bicycle Attorney as part of a general sponsorship package. All opinions in the article are that of the author, and do not necessarily reflect those of LABA. Click on the ad for more information.

This morning, the Metro Board of Directors approved moving into the construction phase of its overdue North Hollywood to Pasadena Bus Rapid Transit (BRT) project. The approval [staff report] was not for the full ~$320+million build-out, but for an initial $135 million “preconstruction” phase which finalizes the design and engineering, and starts $44.5 million worth of early construction activity.

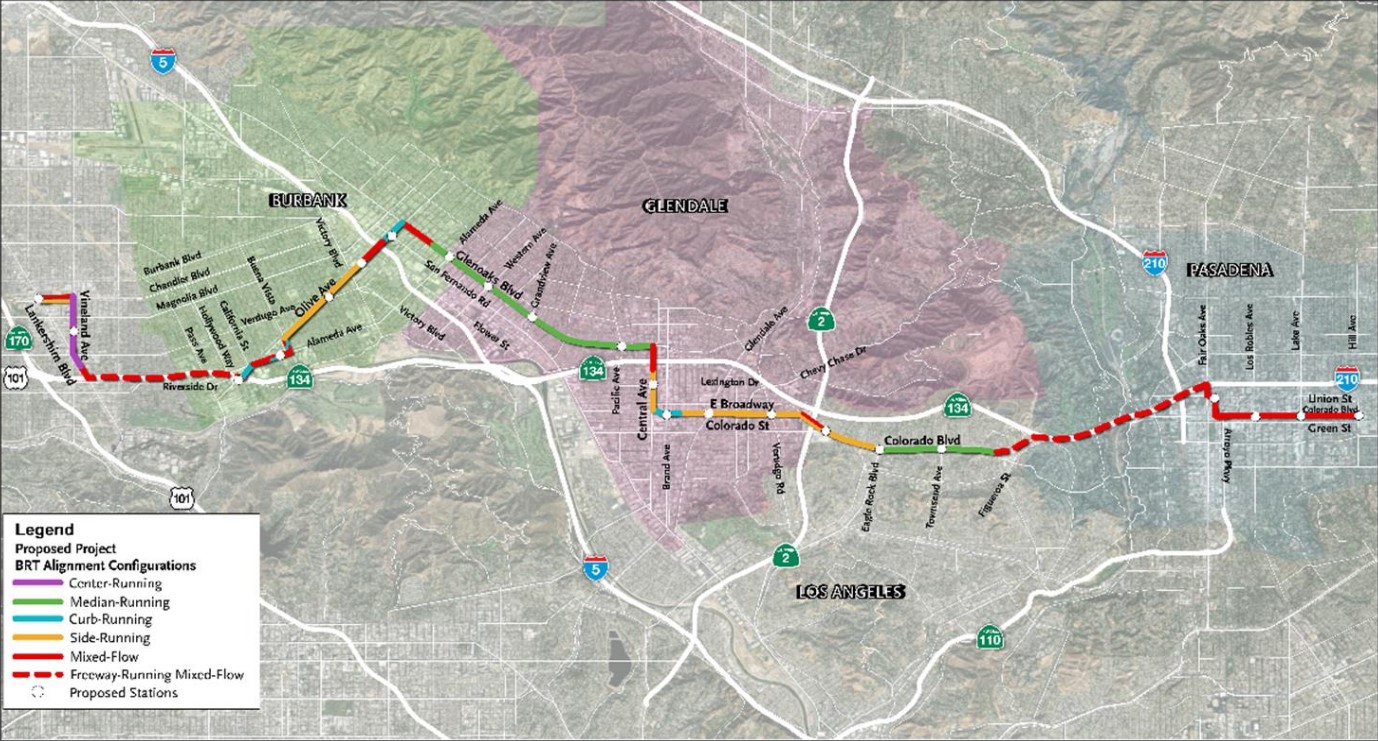

Map of Metro North Hollywood to Pasadena Bus Rapid Transit project

The 19-mile, 22-station BRT project will connect the Metro A Line Memorial Park Station (in Pasadena) to the Metro B and G Line North Hollywood Station. The line will serve the cities of Burbank, Glendale, Pasadena, and the L.A. City neighborhoods of Eagle Rock and North Hollywood.

The project was funded in 2016 via Metro’s Measure M sales tax, which programmed $266 million toward an anticipated 2020-23 groundbreaking and a 2022-25 opening. In 2018, the project received an additional $50 million in state transit capital grant funds.

The planning process was contentious, with some Eagle Rock residents fighting (including filing a lawsuit) against proposed Colorado Boulevard bus lanes. In 2022, Metro approved a fairly ambitious design, largely based on a context-sensitive pro-transit community design.

Some Burbank residents also later protested against bus lanes there.

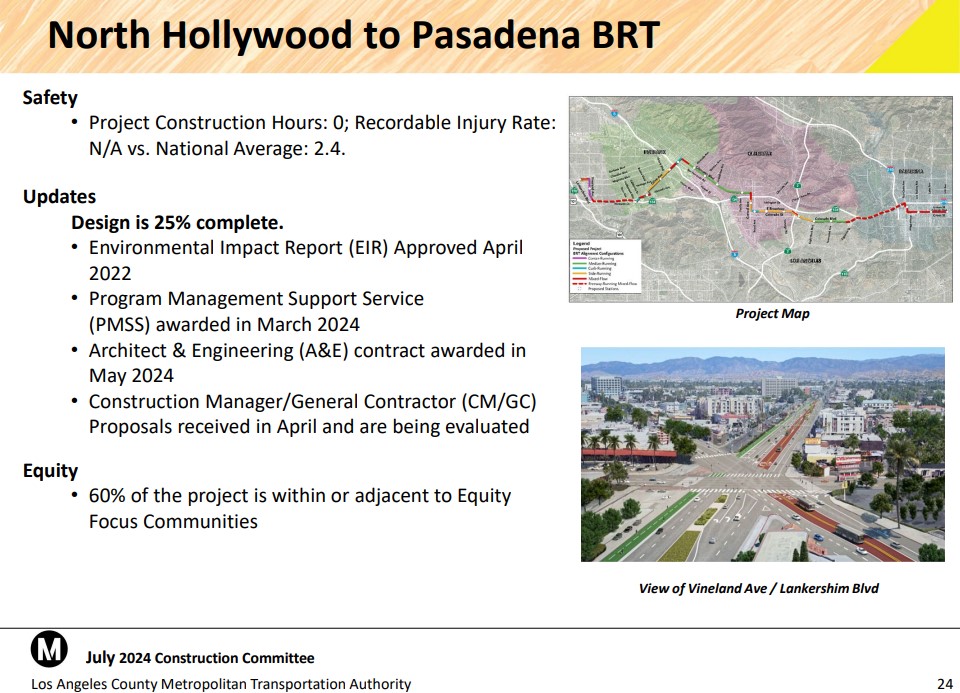

NoHo-Pasadena BRT project status as of July 2024 – via Metro presentation

Since 2022, Metro has awarded two smaller contracts for NoHo-Pasadena BRT project management and architecture/engineering.

Meanwhile Metro construction costs crept upwards faster than sales tax revenue. Delays don’t just mean local bus riders are missing out; if Metro doesn’t get construction underway fairly soon, the project might not open until after the 2028 Olympic and Paralympic Games.

The approval of $135M today will take the project through the next two years. It brings onboard the BRT project Construction Manager/General Contractor (CM/GC) to get early work underway, mainly utility investigation and relocation. If this preconstruction (and final design) phase goes as planned, the project will ramp up into full construction by 2027.

Streetsblog has migrated to a new comment system. New commenters can register directly in the comments section of any article. Returning commenters: your previous comments and display name have been preserved, but you'll need to reclaim your account by clicking "Forgot your password?" on the sign-in form, entering your email, and following the verification link to set a new password — this is required because passwords could not be carried over during the migration. For questions, contact tips@streetsblog.org.
